Detached ADU Builders in Utah

Last reviewed: June 27, 2026 · Sources: Utah Code §10-21-303 — Internal ADUs; §10-21-304 — Detached ADUs (SB 284, effective Oct 1, 2026); Utah Office of the Property Rights Ombudsman. Local rules can change after state legislation or city ordinance updates. Always verify final eligibility with the city before purchasing plans, ordering prefab units, or applying for financing.

Check city rules, real costs, and the right builder path — before you spend money on plans.

A detached ADU is often the best option in Utah for privacy, rental income, and multigenerational living. It's also the hardest and most expensive ADU path — and rules vary sharply by city. If your lot qualifies and your budget supports it, a detached ADU can meaningfully increase your property's utility, rental potential, and market value. It's also one of the strongest rental income plays in Utah housing right now — well-located units command $1,200–$2,500/month. If your lot is small, your budget is tight, or you need the fastest path, a garage conversion, attached addition, or basement ADU may be smarter. Not sure which is right for your situation? See our ADU vs. home addition guide or the basement vs. detached ADU comparison.

We built this guide to help you make that call before you write a check. Below: a city-by-city rule matrix you won't find anywhere else, realistic Utah cost ranges, a builder-type decision framework, and a free way to check whether your property qualifies.

Your best first step is a feasibility check on your specific lot — not a design deposit.

Last updated: June 27, 2026 · City rules last verified: June 27, 2026 · By the Utah ADU Builders Research Team

Detached ADU Builders in Utah — modern wood-and-metal-panel detached accessory dwelling unit with Wasatch Mountain backdrop, professional landscaping and stone paver driveway, illustrating high-quality detached ADU construction across the Wasatch Front

At a Glance: Detached vs. Other Utah ADU Paths

Before you commit to a detached build, know your options. This is the decision most Utah homeowners get wrong — they lock into "detached" before confirming it's actually the best fit for their lot, budget, and goals.

Detached New BuildGarage ConversionAttached AdditionBasement / Internal
Best forPrivacy, rental income, multigenerational livingBudget-conscious, existing structureExpanding your home, shared wall saves costLowest cost, fastest approval
Typical Utah cost$200K–$400K+$60K–$150K$150K–$250K$50K–$100K
Permit difficultyModerate–high (full site plan, utility review, inspections)Low–moderateModerateLow (state law protects internal ADUs)
PrivacyHigh — fully separate structureHigh if freestandingLower — shared wallLowest — shared structure
Timeline6–14 months3–6 months5–10 months2–5 months
Biggest riskUtility/site costs blow budgetLosing garage parkingAlters main home structureLower rental value
Our takeBest long-term asset if lot and budget allowBest value play if you have a detached garageGood middle ground for larger lotsStart here if budget is under $120K

If you already know detached is right, keep reading — we'll walk you through every detail. If you're not sure yet, this table and the sections below will help you decide.

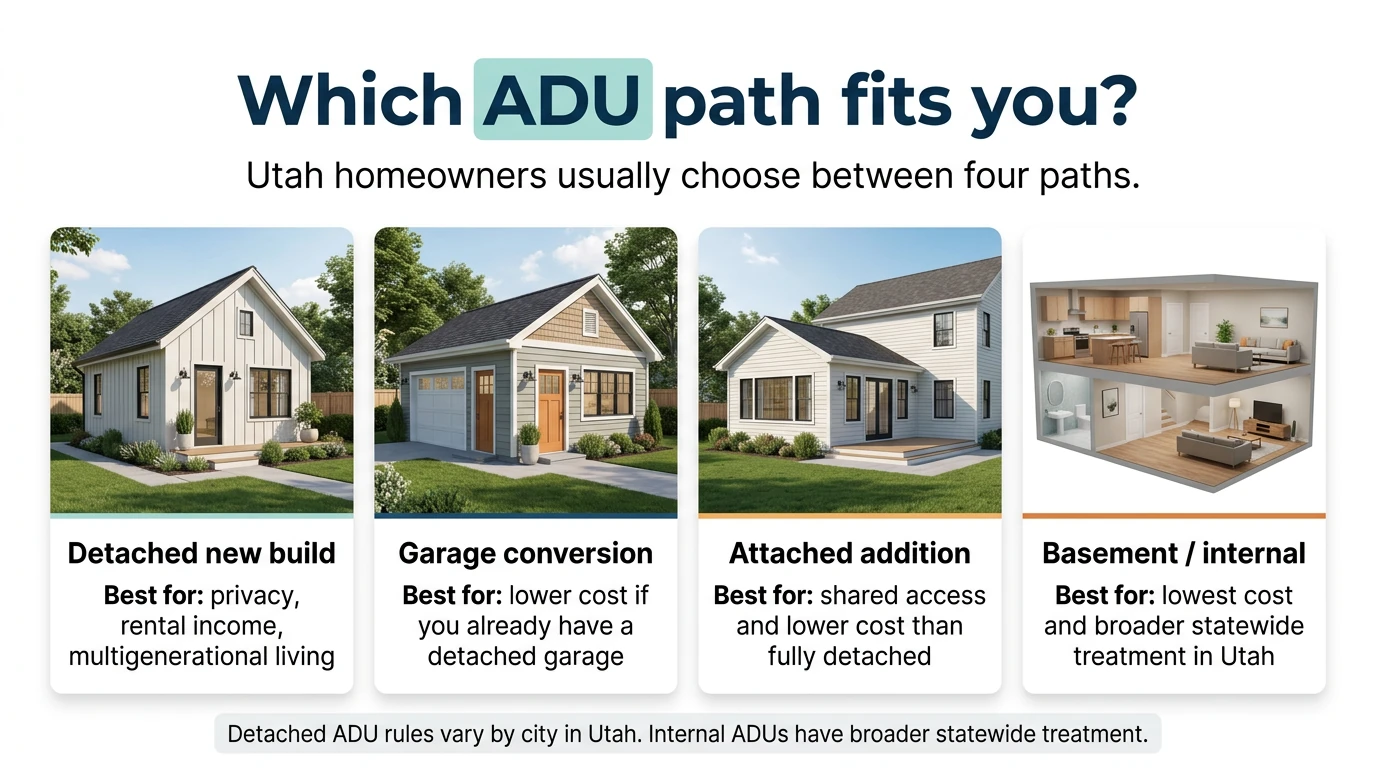

Which ADU path fits you? Infographic comparing four Utah ADU options — Detached new build (best for privacy, rental income, multigenerational living), Garage conversion (best for lower cost if you have a detached garage), Attached addition (best for shared access and lower cost than fully detached), Basement/internal ADU (best for lowest cost and broader statewide treatment in Utah)
Four ADU paths for Utah homeowners — detached rules vary by city; internal ADUs have broader statewide protection.

Not Sure Which Path? Get a Free Recommendation

Tell us your address and goals — we'll verify your options, confirm what your city allows, and recommend the best ADU path for your specific lot.

Can You Build a Detached ADU on Your Utah Lot?

Sometimes yes, often no — and the answer depends far more on your specific city, lot, and zoning district than on whether "Utah allows ADUs" in general.

Here's the reality most builder websites won't tell you upfront: Utah state law (HB 82, 2021) requires all municipalities to allow internal ADUs — basement apartments, basically. That's state-mandated. But detached ADUs? Those are regulated city by city, and each city sets its own rules for size, height, setbacks, parking, utilities, and whether you even need a conditional use hearing or just a building permit. The differences are significant. Salt Lake City lets you build up to 1,000 square feet with 3-foot setbacks and a streamlined permit process. Draper requires a 12,000-square-foot lot minimum. Spanish Fork requires four off-street parking spaces. Orem doesn't allow detached ADUs at all — only accessory apartments within the main residential building.

Same state. Completely different rules. Your project lives or dies based on what your city allows on your lot.

2026 Utah detached ADU law update (SB 284)

Utah SB 284 created Utah Code §10-21-304, effective October 1, 2026. In a "specified municipality," cities must allow one detached ADU on lots or parcels of 11,000 square feet or larger where a single-family home is allowed, and cities may allow detached ADUs on smaller lots. Cities may still regulate size, height, setbacks, lot coverage, design compatibility, utility capacity, owner-occupancy, front-yard placement, short-term rental use under 90 days, and whether more than one ADU is allowed. Local permits and building, fire, utility, and health-code review still apply.

See city-by-city detached ADU lot size requirements →

The 7-Point Lot Check (Do This Before Anything Else)

Before you call a builder, talk to an architect, or fall in love with a floor plan, run through these seven questions. If you can't answer them, a qualified builder can — and that's exactly what our free feasibility estimate covers.

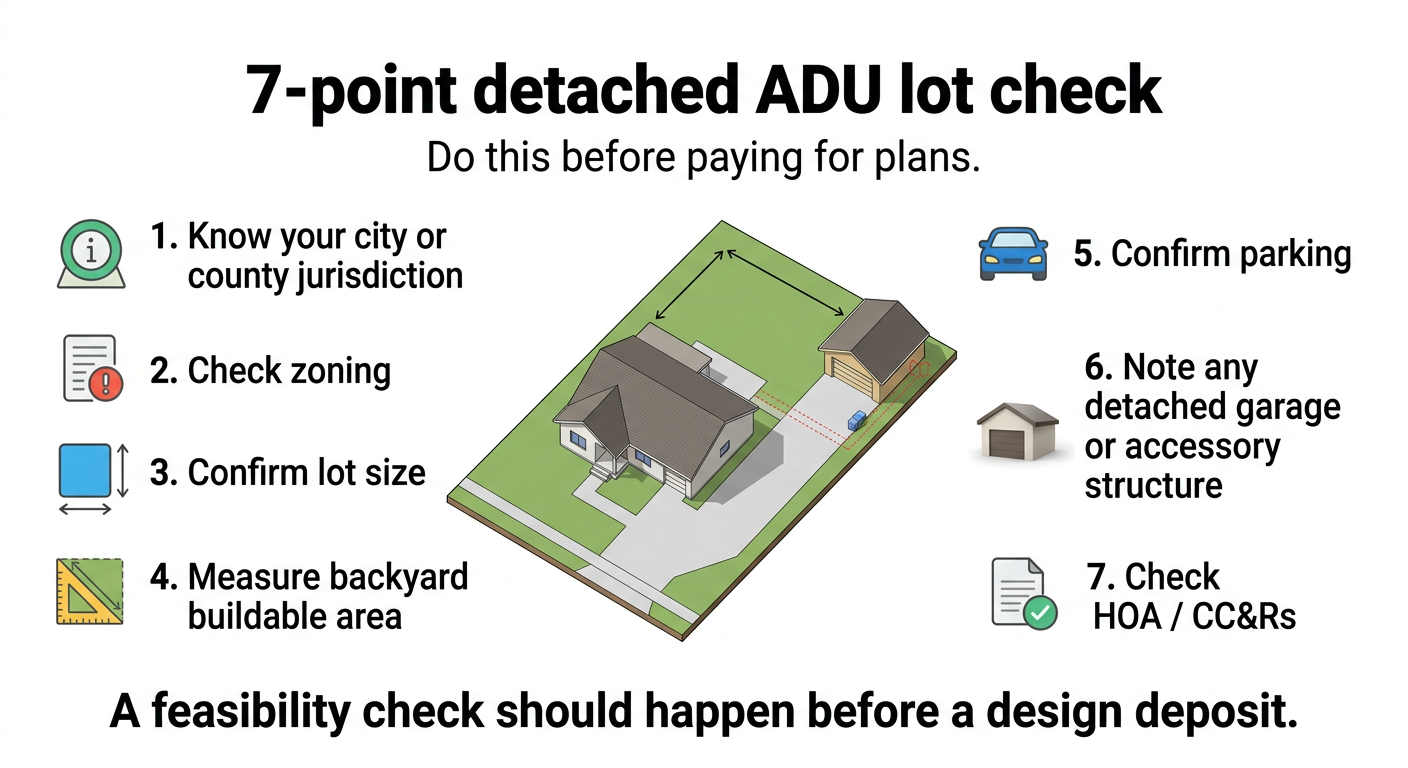

7-point detached ADU lot check infographic — do this before paying for plans: 1. Know your city or county jurisdiction, 2. Check zoning, 3. Confirm lot size, 4. Measure backyard buildable area, 5. Confirm parking, 6. Note any detached garage or accessory structure, 7. Check HOA/CC&Rs. A feasibility check should happen before a design deposit.
Run through all seven points before committing to a design deposit — a qualified builder handles this in a free feasibility consultation.
  1. 1. What city or county jurisdiction is your property in? Not your mailing address — your actual municipal jurisdiction. Unincorporated Salt Lake County has different rules than Salt Lake City.
  2. 2. What's your zoning designation? Most detached ADUs require R-1 single-family residential or Agriculture zones.
  3. 3. How big is your lot? Minimums range from 6,000 to 12,000+ square feet depending on your city.
  4. 4. How much rear-yard space do you actually have? Detached ADUs must go in the rear yard in nearly every Utah jurisdiction. Setbacks eat into that space fast.
  5. 5. Can you add a parking space? Almost every city requires at least one additional off-street parking spot for the ADU.
  6. 6. Do you have an existing detached garage or accessory structure? Converting an existing structure is often cheaper and faster than building new — and may have different setback rules.
  7. 7. Are you in an HOA? State law says HOAs cannot block internal ADUs that comply with local code. But detached ADUs? Your CC&Rs may have authority to restrict them. Check before you design.
The honest truth about feasibility: Detached ADUs offer the most flexibility of any ADU type — and they're also the easiest to kill with zoning, parking, or utility details. The good news? You can usually catch the deal-breakers before spending a dollar on plans.

Get a Free Lot Feasibility Check

Give us your address and we'll confirm zoning, lot size, setbacks, parking requirements, and utility access — usually within 48 hours. Free, no commitment.

Which Utah Cities Allow Detached ADUs — and What Are the Rules?

There is no single Utah rulebook for detached ADUs. The same project concept can look perfectly legal in Salt Lake City, get downsized in Ogden, drown in parking requirements in Spanish Fork, and require a conditional use hearing in Cottonwood Heights. We pulled the actual rules from official city and county sources so you can see exactly where you stand.

City / CountyDetached Allowed?Min Lot SizeMax ADU SizeMax HeightSetbacksParkingOwner-Occupancy?Separate Meters?STR Allowed?
Salt Lake CityYesZoning-dependent1,000 sqft (must be < primary)17ft; up to 24ft pitched / 20ft flat with increased setbacks3ft side/rear; 10ft corner1 additionalYesVerify with Public UtilitiesNo (detached)
Salt Lake County (unincorp.)Yes7,000 sqft (6,000 in PC Zone)Zoning-dependent20ft or match primary10ft rear; 6ft from main house1 additionalYes (affidavit)Yes (owner gets both bills)No
MillcreekYes8,000 sqft1,000 sqftPer accessory structure rules5ft side/rear1 additionalYesNo — must run from mainNo (detached)
DraperYes12,000 sqftMax 50% of primary dwelling35ftRear yard only1 additional (no tandem)YesNo separate meters30-day minimum
ProvoYes (limited)Zoning-dependentMust be < primary dwellingMust be < primary10ft from property linesRequiredYesAt least 1, no more than 2 meters in owner's nameNo
South Salt LakeYesZoning-dependentCity-determinedCity-determinedPer zoneRequiredYes (owner or immediate family)City-determined30-day min; permit + annual license if rented
OgdenYesZoning-dependent800 sqftPer codePer zoneRequiredYesCity-determinedCheck local code
Cottonwood HeightsConditional useZoning-dependentCity-determinedCity-determinedPer zone2 additionalYesCity-determinedCheck local code
LehiYes14,520 sqft1,300 sqft finished living areaNot greater than primary, max 35ftPer zone setbacks2 additional (no tandem)YesNo — connected to primary dwellingNo
Spanish ForkYes6,000 sqftCity-determinedCity-determinedPer zone4 off-streetYesSeparate electric not requiredAnnual registration ($60/yr)
BountifulConditional use (Admin Committee)Zoning-dependentCity-determinedCity-determinedPer zoneRequiredYesCity-determinedCheck local code
North Salt LakeYesZoning-dependentCity-determinedCity-determinedPer zoneRequiredYesCity-determinedCheck local code
West JordanYes (SF/rural only)10,000 sqftMust be < primary footprintPer zone6ft side/rear; 20ft corner; 6ft from primary1 additional (9'×18', paved)YesNo separate metersNo (30-day min)
MurrayYes10,000 sqftMax 50% of primary or 1,000 sqft (whichever is less)20ft / 1 story10ft side/rear; not in front yard1 additional (total 3 on-site)Yes (affidavit recorded)City-determinedNo (30-day min; business license required)

Data sourced from official city/county code pages, ADU handbooks, and permit pages. "City-determined" means the rule exists but varies by zoning district — contact the city or request our free feasibility check for your specific address. Regulations change frequently; always confirm with your local planning department before committing to plans. Last reviewed: March 2026.

Newly completed Utah detached ADU exterior — farmhouse-style accessory dwelling unit with board-and-batten siding, metal roof, covered front porch, and number 214, surrounded by drought-tolerant landscaping with Wasatch Mountains in the background at golden hour
A permitted detached ADU in a Utah residential backyard — covered entry, board-and-batten siding, xeriscape landscaping

What the City Examples Tell You

The differences aren't minor. A few that matter most:

Salt Lake City is one of the most ADU-friendly cities in Utah. Detached ADUs can go up to 1,000 square feet (but must remain smaller than the primary dwelling). Height can increase to 24 feet for a pitched roof if you increase setbacks. Side and rear setbacks are just 3 feet — generous by Utah standards. SLC also publishes a library of pre-approved standard ADU plans at slc.gov/buildingservices — using one can shave 4–8 weeks off permitting. One detail that matters: SLC fire code requires the ADU to be within 150 feet of a public right-of-way for fire access.

Salt Lake County (unincorporated areas) adopted a new ADU-friendly ordinance in June 2024 specifically to reduce restrictions and increase ADU adoption. Detached ADUs need a lot of at least 7,000 square feet (6,000 in the PC Zone). Maximum height is 20 feet or matching the primary home. The county requires a concrete slab foundation for detached ADUs — no basements, piers, or temporary foundations (the exception: above-garage ADUs). Detached ADUs can have separate utility meters, but the property owner must receive bills for both units. Owner occupancy is required and must be documented with a recorded affidavit.

Draper has one of the strictest lot minimums on the Wasatch Front: 12,000 square feet for a detached ADU. Maximum ADU size is 50% of the primary dwelling's floor area, with a 35-foot height cap. Parking spaces cannot be tandem (one blocking another). No separate utility meters are allowed. If you're in Draper with a smaller lot, your options are internal (basement) or possibly attached.

Spanish Fork requires four off-street parking spaces for external ADUs and annual registration. That parking requirement alone can be a project-killer on smaller lots.

Cottonwood Heights treats detached ADUs as conditional use — meaning you'll need a public hearing before the planning commission, not just a building permit. They also require two additional parking stalls. This adds time, uncertainty, and cost to the approval process.

Ogden caps detached ADUs at 800 square feet — smaller than the 1,000-square-foot maximum that most other Wasatch Front cities allow. This limits your design options and rental income potential.

Murray requires a 10,000-square-foot lot for detached ADUs. Maximum size is 50% of the primary dwelling or 1,000 square feet, whichever is less. Height is capped at 20 feet and one story, with 10-foot side and rear setbacks. Murray does not allow owner-building — you must hire a licensed contractor. A business license is required if you plan to rent.

Bountiful allows detached ADUs, but they're classified as conditional use and require Administrative Committee approval — an extra step beyond what most cities require. Plan for additional review time.

Don't See Your City?

ADU ordinances are changing fast across Utah. If your city isn't in this matrix, here's what to collect before your first builder conversation:

  • • Your city's ADU or accessory dwelling ordinance (usually in the municipal code under "accessory uses" or "supplementary regulations")
  • • Lot size minimums for detached ADUs
  • • Maximum size, height, and setback requirements
  • • Parking requirements
  • • Owner-occupancy and rental rules
  • • Utility meter rules (separate allowed or not?)

Or skip the homework — a qualified local builder can pull all of this for your specific address.

Confirm My City + Lot Eligibility — Free

We verify your address against your city's current detached ADU ordinance and lot requirements — typically within 48 hours. No obligation.

Is a Detached ADU the Right Move — Or Would Another Type Save You Money?

Detached wins on privacy and flexibility. It usually loses on cost, utilities, and permit friction. Here's when each path makes sense.

Detached New Build vs. Garage Conversion

If you have an existing detached garage you're willing to give up (or build above), a garage conversion is almost always cheaper. You skip the foundation, you skip most site work, and you may benefit from grandfathered setbacks. The tradeoff: you lose your garage, and most cities require you to replace the parking — so you may need a new carport or driveway space. A garage conversion typically runs $60,000–$150,000 in Utah. A new detached build starts around $200,000 and can easily reach $400,000+. That's a meaningful difference.

Detached vs. Attached Addition

An attached ADU shares a wall (and often a foundation and roofline) with your main home, which cuts structural and utility costs. Typical range in Utah: $150,000–$250,000. The downside: less privacy, and you're altering your primary home's footprint. For multigenerational living where some connection to the main house is desirable, attached can be ideal. For rental income where tenants want full independence, detached is better.

Detached vs. Basement / Internal ADU

Internal ADUs are the most affordable path ($50,000–$100,000) and have the strongest legal protections — Utah state law requires all municipalities to allow them. No separate foundation, no utility trenching, no site work. The rental income potential is lower (typically $800–$1,500/month vs. $1,200–$2,500 for detached), but the ROI can actually be faster because the upfront cost is so much lower.

When Detached Is Absolutely Worth the Extra Cost

Go detached if:

  • You want maximum rental income. A 2-bedroom, 800–1,000 sqft detached ADU commands the top of Utah's rental market — $1,800–$2,500/month in strong neighborhoods.
  • You're housing a family member who needs real independence. An aging parent, adult child, or caregiver deserves their own front door, their own kitchen, their own space. Detached delivers that in a way no basement apartment can.
  • You're thinking about long-term property value. A well-built detached ADU is essentially a second home on your lot. It can meaningfully increase your property's appraised value and makes your home dramatically more attractive to future buyers.
  • Your lot can support it. You have the square footage, the setbacks, the utility access, and the budget.
Don't go detached if your lot is tight, your budget is under $150K, or you need to be generating income within 6 months. There's no shame in a different path — and a smarter choice now saves you from a painful pivot later.

How Much Does a Detached ADU Cost in Utah?

Most Utah homeowners pay $200,000–$400,000+ total for a new detached ADU. That breaks down to roughly $200–$350 per square foot for construction, plus $25,000–$75,000 in site work, permits, utility connections, and design fees.

Those numbers are planning-level estimates based on published builder quotes, municipal fee schedules, and industry data across the Wasatch Front. Your actual cost will depend on your lot, your city, your builder, and your finish choices. Here's where that money actually goes.

Full Cost Breakdown

Cost ComponentTypical RangeWhat Drives It
Design & architecture$10,000–$30,000Custom vs. pre-approved plans, complexity, engineering
Permits & plan review$2,000–$5,000Varies by city
Impact fees$3,000–$10,000City-specific; covers roads, parks, water infrastructure
Site preparation$5,000–$20,000Excavation, grading, tree removal, equipment access
Foundation$10,000–$25,000Concrete slab (required in SL County); frost depth 30–36"
Construction (shell + finish)$120,000–$300,000+Size, finishes, complexity — the bulk of your budget
Utility connections$10,000–$30,000Sewer, water, electrical, gas; distance from main house matters enormously
Landscaping repair$3,000–$10,000Restoring yard after construction

Cost by Size and Finish Level

ADU SizeStandard (~$200/sqft)Mid-Range (~$275/sqft)Premium (~$350/sqft)
400 sqft~$80,000~$110,000~$140,000
600 sqft~$120,000~$165,000~$210,000
800 sqft~$160,000~$220,000~$280,000
1,000 sqft~$200,000~$275,000~$350,000

Planning-level construction estimates based on Wasatch Front builder data. Add $25K–$75K for design, permits, site work, and utility connections. Actual costs vary by lot, city, builder, and finish selections — get a project-specific estimate before budgeting.

Why Most People Should Build to Maximum Size

This is counterintuitive, but it's the most important cost insight for detached ADUs: the fixed costs are enormous, and additional square footage is relatively cheap. Foundation, permits, utility trenching, design, site work — these cost nearly the same whether you build 400 square feet or 1,000. Going from 600 to 1,000 square feet might add $50,000–$80,000 in construction cost, but you gain a second bedroom, significantly higher rental income, and substantially more property value. From a pure ROI standpoint, building to your city's maximum allowable size almost always makes sense.

The Hidden Costs That Surprise People

These are the line items that blow budgets when builders don't flag them upfront:

  • Utility trenching. If your planned ADU location is 80+ feet from existing utility connections, trenching alone can add $15,000–$30,000. This is the single biggest cost wildcard.
  • Sewer capacity confirmation. Your city's public utilities department must confirm drain grade and slope. If the grade doesn't work, you may need a pump system — a major added cost.
  • Power panel upgrade. If your main panel can't support a second dwelling's electrical load, upgrading to a 400-amp service can run $3,000–$8,000.
  • Retaining walls and drainage. Sloped lots can add $20,000–$50,000+ for engineered retaining walls and stormwater management. Millcreek outright prohibits ADUs on slopes greater than 30%.
  • Access constraints. If construction equipment can't reach your backyard without going through the house or over a fence, access staging adds time and cost.
  • Snow load and seismic engineering. Utah's Wasatch Front requires designing for 30–50+ psf ground snow loads depending on elevation. Seismic design is mandatory per the International Residential Code. These aren't optional — they're code requirements that affect structural costs.

How to Reduce Cost Without Cutting Corners

  • • Use SLC's pre-approved standard plans (available if you're building in Salt Lake City)
  • • Keep the footprint simple — rectangular, single-story, one plumbing wall
  • • Choose standard finishes: LVP flooring, laminate counters, stock cabinets
  • • Build close to existing utility connections
  • • Consider a garage conversion if you have an existing detached structure
  • • Get multiple detailed bids — not lump-sum quotes, line-item breakdowns

Get a Detailed Cost Estimate for My Lot

A vetted Utah ADU builder reviews your address, lot conditions, and goals — and gives you a realistic all-in number with no commitment required.

How Long Does a Detached ADU Take from Zoning Check to Move-In?

Total timeline: 6–14 months. The biggest variable is permitting, which takes 1–4 months depending on your city's backlog and your plan complexity. Construction itself typically runs 4–8 months.

Here's the phase-by-phase breakdown:

Phase 1: Feasibility + Zoning Check (1–2 Weeks)

Confirm your lot's zoning, setbacks, parking, lot coverage, and utility access. A qualified builder handles this in the initial consultation. This is what our free feasibility estimate covers — and it's the most important two weeks of the entire project. A deal-breaker caught here saves you months and thousands.

Phase 2: Design + Engineering (3–8 Weeks)

Architectural plans, structural engineering, site plan, mechanical/electrical/plumbing design. If you're using a city's pre-approved plans (SLC offers these), this phase can shrink to 2–3 weeks. Custom designs take longer, especially for complex lots or above-garage builds.

Phase 3: Permitting + City Review (4–16 Weeks)

Submit your application to Planning & Zoning. The city reviews for zoning compliance, building code, fire code, and utility capacity. Some cities (like Millcreek) require site plan review by the Planning Commission for new detached ADUs. SLC's pre-approved plans can shave 4–8 weeks off this phase.

Key Utah law: In most cases, a licensed general contractor must pull the building permit for a detached ADU. Salt Lake City's ADU Handbook specifically requires this (citing Utah Code 58-55-301 and 58-55-305). Limited statutory exemptions exist, but for the vast majority of detached ADU projects, you need a licensed GC. Don't let anyone tell you otherwise.

Phase 4: Construction (4–8 Months)

Site prep → foundation → framing → roofing → rough-in (mechanical, electrical, plumbing) → insulation → drywall → finishes → utility connections → landscaping repair. Multiple inspections throughout: foundation, four-way framing, utility connections, and final.

Utah's climate adds construction considerations that matter. The Wasatch Front requires designing for ground snow loads of 30–50+ psf depending on your elevation and specific jurisdiction. Seismic design is mandatory — Utah sits on active fault lines, and the IRC requires engineered seismic resistance. Foundation depth must account for frost depth (30–36 inches in most Wasatch Front locations). Concrete work is best done in warmer months; exterior work can stall during January and February freezes.

Fire separation is another Utah code requirement that affects detached ADU construction. Per IRC R302.1, exterior walls must meet fire separation distance requirements. If your ADU is near an existing garage, fire separation between the garage and dwelling unit applies (R302.5-6). These aren't design preferences — they're code requirements your builder must address in the plans.

Phase 5: Final Inspection + Certificate of Occupancy (2–4 Weeks)

City building department final inspection, fire department sign-off (SLC requires the ADU to be within 150 feet of public right-of-way for fire access), Certificate of Occupancy issuance, and recording of owner-occupancy affidavit if you plan to rent.

What Usually Delays Utah ADU Projects

  • • City comments requiring plan revisions (the #1 delay)
  • • Utility capacity issues discovered during permitting
  • • Parking or driveway redesign requirements
  • • Setback miscalculations caught during review
  • • Scope changes mid-construction (change orders)
  • • Weather — Utah winters can halt exterior work for weeks
  • • Contractor scheduling conflicts (peak season: April–October)
The single best thing you can do to avoid delays: hire a builder who has permitted and completed detached ADUs in your specific city before. They know the reviewers, the common objections, and the submission format that gets approved fastest.

What Kind of Builder Should You Hire for a Detached ADU?

When you search for "detached ADU builders Utah," you get a mix of architects, general contractors, prefab companies, and builder service pages — with no guidance on which type you actually need. Here's the framework we use:

Utah main house and detached ADU at dusk — craftsman-style primary home with warm lit windows and covered porch on left, connected by stone paver path through lush garden to a cedar-sided detached ADU cottage with orange-lit entrance on right, illustrating multigenerational living and income potential of a permitted detached accessory dwelling unit
A permitted detached ADU at dusk — separate entrance, connected by a garden path, fully independent living unit

Builder Path Decision Framework

Builder TypeBest If…Avoid If…Handles Zoning?Handles Design?Handles Permitting?Handles Utilities?Budget PredictabilityBiggest Risk
Design-build ADU specialistYou want one team from concept to keysYou already have architect plansYesYesYesYesHighFewer design options than independent architect
Architect + separate GCYou want maximum design controlBudget is tight, timeline is shortArchitect: sometimes. GC: rarelyYes (architect)Split responsibilityGC handlesMedium — two contractsCoordination gaps between architect and builder
Remodel / addition GCSimple attached or garage conversionComplex detached new buildSometimesBasicUsuallySometimesMediumMay lack detached ADU-specific experience
Prefab company + local installerYou want speed and cost certaintyComplex lot, steep slope, tight accessRarelyLimited to their modelsPartiallyInstaller handlesHigh for structure; variable for siteSite work/utilities still unpredictable
Garage conversion specialistYou have an existing detached garageYou need a ground-up buildSometimesBasicUsuallyUsuallyHighLimited to conversion scope

When a Design-Build ADU Contractor Is the Best First Call

For most Utah homeowners building a detached ADU, this is the right answer. A design-build firm handles architecture, engineering, permitting, construction, and utility coordination under one contract. You have one point of contact, one timeline, and one entity responsible for the outcome. The key qualifier: make sure they have detached ADU-specific experience in your city. General home building is not ADU building. ADUs have unique zoning challenges, utility coordination requirements, and code provisions that a tract-home builder may not know.

When You Need an Architect First

If you have a complex lot (steep slope, unusual setbacks, an existing structure to work around), hiring an architect first gives you maximum design control. The architect creates plans, and you then hire a general contractor to build them. The tradeoff: you manage two relationships, timelines can stretch, and there's inherent coordination friction between designer and builder.

When Prefab Sounds Good — and When It Doesn't

Prefab/modular ADUs can save 2–4 months on timeline and offer strong cost predictability for the structure itself. But prefab doesn't erase local reality. You still need: site preparation, foundation, utility trenching and connections, permitting, inspections, setback compliance, and transportation/crane logistics. The "total project cost" for a prefab ADU is typically 3–5× the structure price. A $50,000 prefab unit can easily become a $200,000 total project. Prefab works best on flat, accessible lots with standard setbacks and close utility connections. It struggles with slope, tight access, unusual lot configurations, or cities with strict architectural compatibility requirements (like Provo, which requires ADUs to match the main home's materials and style).

How to Compare Detached ADU Builders Without Getting Burned

The right builder isn't the one with the prettiest website. It's the one who can show detached-ADU experience in your specific city, handles permits and utilities proactively, and gives you a detailed line-item estimate — not a lump sum and a handshake.

How to compare Utah detached ADU builders infographic — use this shortlist before you ask for a deposit: Verify Utah contractor license, Ask for detached ADU projects in your city, Ask who handles permits, Ask for line-item estimates, Verify contractor projects in your city, Get a line-item quote, Ask who handles utility coordination, Review insurance and references, Understand exclusions and change orders, Choose detached ADU experience over generic home-building claims
Use this shortlist before you ask a builder for a deposit — the right builder passes all of these.

15 Questions to Ask Every Utah Detached ADU Builder

  1. 1. How many detached ADUs have you completed in my city?
  2. 2. Can you share permit numbers or project addresses I can verify?
  3. 3. Who handles zoning review and any required plan revisions?
  4. 4. Who coordinates utility connections and trenching — you or me?
  5. 5. Is utility trenching and site work included in your quote, or separate?
  6. 6. What's specifically excluded from your estimate?
  7. 7. How are change orders priced and approved?
  8. 8. What happens if the city requires a redesign after submission?
  9. 9. What's your realistic timeline for a project like mine?
  10. 10. Are you a licensed general contractor in Utah? (Verify at dopl.utah.gov)
  11. 11. What's your general liability coverage amount? Workers' comp?
  12. 12. What warranty do you offer — structural and cosmetic?
  13. 13. Will you be on-site supervising, or is everything subcontracted?
  14. 14. Can I talk to a recent detached ADU client of yours?
  15. 15. What's your deposit structure, and when are payments due relative to milestones?

How to Verify a Utah Contractor License

This takes two minutes and can save you from disaster:

  1. 1. Go to Utah DOPL License Lookup
  2. 2. Search by contractor name or company name
  3. 3. Confirm: license is active, classification covers residential construction, and no disciplinary actions

Utah law generally requires a licensed general contractor to pull building permits for detached ADUs (Utah Code 58-55-301). If someone offers to build your ADU without being licensed — or says "we'll have someone else pull the permit" — that's a serious red flag.

Red Flags That Should End the Conversation

🚩

No detached ADU portfolio. Additions and custom homes are not the same thing.

🚩

"We handle everything" with no specifics about permitting process. This usually means they don't handle permitting at all.

🚩

Lump-sum quote with no line items. You have no way to know what's included.

🚩

No line item for utilities or site work. These are the costs that blindside people.

🚩

Pressure to sign or deposit before feasibility. A confident builder will let the project sell itself.

🚩

Can't provide references for ADU projects in your city. City-specific experience matters more than total projects completed.

🚩

No proof of insurance. Ask for a certificate of insurance. If they hesitate, leave.

Get Matched With Vetted Utah ADU Builders

All builders in our network are licensed, insured, and have completed permitted detached ADUs in Utah. We match you to the right builder for your city and lot type.

Which Builder Path Fits Your Exact Situation?

Different goals need different approaches. Find yourself below.

"I'm building for rental income."

Best path: Design-build ADU specialist.

Build to maximum allowable size (usually 1,000 sqft), 2 bedrooms, mid-range finishes that are durable and tenant-friendly (LVP floors, quartz or solid-surface counters, stock cabinets). Focus on maximizing rentable square footage, not luxury details.

Why: A 2BR/1BA detached ADU in a strong Wasatch Front neighborhood rents for $1,800–$2,500/month in 2026. At $2,000/month, that's $24,000/year — and the unit is simultaneously building equity.

Key tradeoff: Higher upfront cost ($200K–$350K), but highest long-term return.

"I'm building for an aging parent."

Best path: Design-build specialist with ADA experience, or architect + GC for complex accessibility needs.

Single-story, 600–800 sqft, with wider doorways (36"), a roll-in shower or walk-in with grab bars, no-step entry, and good lighting. Proximity to the main house matters — you want to be close enough to help, far enough for independence.

Why: An on-site ADU for an aging parent can replace $4,000–$8,000/month in assisted living costs. It's also more dignified, and allows your family to provide direct care.

Key tradeoff: Design-build simplifies management. For very complex medical needs, the architect-first path gives more customization.

"I have an existing detached garage I'd convert."

Best path: Garage conversion specialist or a design-build firm with conversion experience.

This is almost always the most cost-effective detached ADU path — $60,000–$150,000 depending on condition and scope. You may benefit from grandfathered setbacks, skip the foundation pour, and dramatically shorten the timeline.

Why: You may benefit from grandfathered setbacks and significantly reduced site work costs.

Key tradeoff: You lose your garage. Most cities require replacing the parking — check if a carport or driveway space satisfies the requirement.

"My lot is small or awkward."

Best path: Architect first (for creative space planning), then a builder experienced with constrained sites.

Consider an above-garage ADU — building up instead of out preserves yard space. SLC allows up to 24 feet for pitched roofs with increased setbacks. Or consider whether an attached addition or internal ADU is actually the smarter play.

Why: Complex lots cost more. Budget 15–25% above standard estimates for engineering, retaining walls, or unusual access logistics.

Key tradeoff: Complex lots cost more and may limit your ADU type options.

"I want the fastest approval."

Best path: Use pre-approved city plans where available (SLC has a library of them), or choose a prefab model that's been permitted in your city before.

A design-build firm that has completed multiple projects in your city will know exactly what the reviewers expect.

Why: Pre-approved plans can cut 4–8 weeks from the permit phase alone.

Key tradeoff: Less design customization. Worth it if speed matters more than a bespoke floor plan.

"I want the lowest total project cost."

Best path: Garage conversion first.

If no garage exists, consider a smaller detached footprint (400–600 sqft) with standard finishes, or explore internal/basement ADU as an alternative. Every dollar saved on site work and utilities is a dollar saved permanently.

Why: Lower rental income potential, but faster ROI if you're budget-conscious.

Key tradeoff: Lower rental income potential. But faster ROI if you're budget-conscious.

What Can Derail a Detached ADU Project in Utah?

Most detached ADU failures happen before framing begins. Here's what to watch for — and how to avoid each one.

Assuming "Utah Allows ADUs" Means Your City Allows Your Detached Plan

State law protects internal ADUs. Detached ADUs are governed by your city's ordinance, and those ordinances vary wildly. Always verify city-specific rules for your property before investing in design.

Underestimating Utility Trenching and Site Work

This is the #1 budget-buster. If your planned ADU location is far from existing sewer, water, and electrical connections, trenching costs can add $15,000–$30,000+ to your project. SLC's own ADU guidance flags drain grade and slope as "a major up-front issue." Get a utility assessment early.

Missing Parking or Driveway Constraints

Almost every Utah city requires at least one additional off-street parking space for a detached ADU. Spanish Fork requires four. If your driveway and lot can't accommodate additional parking without redesign, this can force a smaller ADU footprint or even kill the project.

Ignoring Owner-Occupancy and Rental Rules

Most Utah cities require the property owner to live on-site — either in the main house or the ADU. You typically can't rent both the main house and the ADU. If your plan involves renting the whole property, check your city's rules carefully. Some cities require recording an affidavit, obtaining a business license, or completing annual registration.

Thinking Prefab Skips Local Code

A factory-built ADU still needs a foundation, utility connections, site prep, permitting, inspections, and zoning compliance — all governed by your local jurisdiction. Prefab saves time on construction; it doesn't save you from code.

Forgetting HOA / CC&R Restrictions

State law says HOAs cannot block compliant internal ADUs. But for detached ADUs, your HOA or CC&Rs may have authority to impose restrictions or outright prohibit them. Review your governing documents before you design — not after. If you hit a wall, contact the Utah Office of the Property Rights Ombudsman.

Designing Too Much ADU for the Lot

It's tempting to max out every allowable square foot, but some lots can't physically support a 1,000-square-foot ADU once you account for setbacks, parking, lot coverage limits, and utility routing. A good builder will tell you the realistic buildable envelope on your property — not just the theoretical maximum. Sometimes a well-designed 650 sqft unit is smarter than a cramped 1,000 sqft unit that eats your entire backyard.

The pattern here is clear: the projects that go wrong are the ones where someone designed first and checked feasibility second. The projects that go smoothly are the ones where someone confirmed every constraint before committing to plans.

What a Successful Detached ADU Project Can Look Like

Here's a realistic scenario: Your property has a permitted 850-square-foot detached ADU in the backyard. Clean lines, matching the main house's exterior. Two bedrooms, one bath, a small but functional kitchen. A long-term tenant pays rent that covers a significant chunk of your mortgage. Your property appraised noticeably higher than comparable homes without an ADU. Your equity position is stronger. And in five or ten years, when your needs change, that unit can house a family member, serve as a home office, or continue generating income while you travel, retire, or move.

That's not fantasy. That's what happens when you check the rules first, hire the right builder, and build something real. Utah homeowners are doing exactly this across the Wasatch Front — and the ones who plan well don't regret it.

Can You Rent a Detached ADU in Utah?

Yes — long-term, in most cities. But the rules around renting are city-specific, and getting them wrong can result in fines, forced removal, or legal headaches.

Long-Term Rentals (30+ Days)

Allowed in most Utah cities, subject to owner-occupancy requirements, a valid ADU permit, and often a business license. This is the standard path for generating rental income from a detached ADU.

Short-Term Rentals (Airbnb, Vrbo)

Prohibited for detached ADUs in most Wasatch Front cities. Salt Lake City, Millcreek, and Salt Lake County all ban short-term rentals in detached ADUs. Some cities allow STR in internal/attached ADUs but explicitly prohibit it in detached structures. Don't assume your detached ADU can be an Airbnb — verify your city's specific rules.

Owner-Occupancy Requirements

Nearly universal in Utah. The property owner must live on-site — either in the main house or the ADU. Most cities require recording an affidavit or owner-occupancy declaration. Salt Lake County allows short exceptions (up to 2 years) for military deployment, medical services, or religious missions.

Business License and Registration

Required in many cities if you're renting. South Salt Lake requires a permit plus an annual license for any rented ADU. Spanish Fork requires annual registration. These aren't optional — they're conditions of legal operation.

What Happens If You Sell

The ADU cannot be sold separately from the main property — it's part of the same lot. When you sell, the new owner must sign a new owner-occupancy declaration in most jurisdictions. A permitted, income-generating ADU is a selling point, not a complication — but the new owner inherits the same rules.

Rental Income Potential

In 2026, detached ADU rentals on the Wasatch Front typically command:

  • Studio / 1BR (400–600 sqft): $1,200–$1,600/month
  • 1BR (600–800 sqft): $1,500–$2,000/month
  • 2BR (800–1,000 sqft): $1,800–$2,500/month

Location, finish level, and proximity to transit/employment centers drive the range. At $2,000/month average, a detached ADU generates $24,000/year in gross rental income.

What would your ADU rent for?

Our feasibility check includes a rental income estimate for your neighborhood and ADU type — based on current Wasatch Front market data.

Can Pre-Approved Plans, Prefab, or Garage Conversions Save Time or Money?

Sometimes — but none of them erase local site review, code compliance, or utility realities.

Salt Lake City Pre-Approved Plans

SLC publishes a library of pre-approved standard ADU plans through its Building Services department. Using one can save 4–8 weeks on permitting because the building code review is already complete. You still need a site review, all applicable fees, and a building permit. But if you're building in Salt Lake City and don't need a fully custom design, this is one of the smartest shortcuts available.

Learn more: SLC Accessory Dwelling Unit Standard Plans

When a Garage Conversion Beats a New Detached Build

If you have an existing detached garage that's structurally sound, converting it to an ADU is almost always the fastest, cheapest detached path:

  • Skip the foundation pour (existing slab may work)
  • Benefit from grandfathered setbacks (many cities allow existing structures to maintain their current setbacks even if they don't meet current code)
  • Reduce timeline by 3–6 months vs. ground-up construction
  • Cut costs to $60,000–$150,000 range

The tradeoff: you lose your garage. Check whether your city requires replacement parking, and confirm whether the existing structure meets current building and fire codes for habitable space.

What Prefab Still Doesn't Solve in Utah

Prefab ADUs arrive as finished or near-finished structures that are craned onto your lot. The structure cost is predictable. Everything else isn't:

  • Site work: excavation, grading, and access still required
  • Foundation: a concrete slab or pier system must be ready before delivery
  • Utility hookups: sewer, water, electrical, gas must be trenched and connected
  • Permitting: your city reviews the prefab design against local code, just like any other ADU
  • Transportation and crane logistics: if your lot has tight access, overhead lines, or mature trees, getting the unit into your backyard can be its own project

Prefab makes the most sense on flat, accessible lots with standard setbacks and close utility connections. It struggles everywhere else.

How to Pay for a Detached ADU in Utah

A $200,000–$400,000 project needs a financing plan. Here are the most common paths Utah homeowners use, and you can dig deeper into financing an ADU in Utah:

Home equity loan or HELOCThe most popular option. Borrow against your home's existing equity at rates typically lower than construction loans. Works best if you have significant equity built up.

Construction loanA short-term loan specifically for the build, which converts to a permanent mortgage or is paid off upon completion. Requires detailed plans and a signed builder contract.

Cash-out refinanceRefinance your existing mortgage at a higher amount and use the difference for ADU construction. Can make sense if your current rate is already above market.

SLC West Side ADU loan programQualifying West Side Salt Lake City residents can access low-interest construction loans up to $200,000. Rent to income-qualified tenants and you may qualify for 10% loan forgiveness.

FHA and Fannie Mae ADU programsFannie Mae says HomeReady borrowers buying or refinancing a home with an existing ADU may be able to use ADU rental income to qualify. Freddie Mac also allows ADU financing and says ADU rental income can count if requirements are met. FHA allows purchase, rehabilitation, or refinance of properties with a single ADU. Program rules are lender- and scenario-specific — talk to your lender about what applies to your situation.

Personal savings or family loanFor smaller projects (garage conversions) or as a supplement to other financing.

Talk to a lender before you start design. Many homeowners are surprised to learn they have more usable equity than they thought, and ADU-specific loan products are expanding in 2026.

For more on financing options, see our full Utah ADU Construction Financing Guide →

How We Vet Builders and Keep This Page Accurate

Our Builder-Matching Process

  • • We verify active Utah state contractor licenses through DOPL
  • • We confirm completed, permitted detached ADU projects in the builder's stated service area
  • • We review portfolios for quality, variety, and architectural compatibility
  • • We check for complaints or disciplinary actions
  • • We verify general liability and workers' compensation insurance
  • • We evaluate permitting track records and timeline history

Builders in our network meet these criteria. We do not accept payment from builders for ranking or priority placement. Our feasibility estimates are free to homeowners.

How We Verify City Rules

Every row in our city matrix is sourced from official municipal code pages, city/county ADU handbooks, official permit pages, or Utah state/ombudsman resources. Sources include: SLC ADU Handbook v2.2, Salt Lake County Regional Development, Millcreek MKZ 18.71, Provo City Code 14.30.030, Utah Code §10-21-303 (formerly §10-9a-530), Utah Code §10-21-304 — Detached ADUs (SB 284, effective October 1, 2026), Utah Code 58-55-301, and individual city planning departments.

Disclosure

Utah ADU Builders connects homeowners with vetted, licensed ADU contractors. Our feasibility estimates are free to homeowners. We may receive compensation from builders in our network when a project moves forward. This does not affect the information in this guide, the city data in our matrix, or which builder is recommended for your project. This guide is for informational purposes. Zoning regulations change frequently. Always verify requirements with your local planning department or a qualified builder before committing to any construction project.

Frequently Asked Questions About Detached ADUs in Utah

Can I build a detached ADU on a 6,000-square-foot lot in Utah?

It depends on your city. Salt Lake County generally requires 7,000 square feet for detached ADUs (6,000 in the PC Zone). Millcreek requires 8,000. Draper requires 12,000. Some cities don't specify a minimum for detached but limit it through lot coverage and setback math. Check your specific jurisdiction.

Is a detached ADU more expensive than an attached ADU?

Yes, typically by $50,000–$150,000+. Detached ADUs require a separate foundation, independent utility connections, full exterior construction, and more extensive site work. You're building a small home, not adding a room.

What's the cheapest detached ADU path in Utah?

Converting an existing detached garage ($60,000–$150,000). After that, a small prefab unit on a flat, accessible lot with close utility connections ($150,000–$250,000 total project). New custom construction starts around $200,000.

Do I need separate utilities for a detached ADU?

Rules vary. Provo limits utilities to at most two meters, all in the owner's name. Millcreek prohibits separate meters. Salt Lake City and Salt Lake County generally allow separate utility service for detached ADUs, with conditions. This one detail can significantly affect your project cost and design.

Can I build above my detached garage?

In many Utah cities, yes. Salt Lake City allows heights up to 24 feet for pitched roofs with increased setbacks. Salt Lake County waives the concrete-slab foundation requirement for above-garage ADUs. Structural engineering is required. This is a great option for smaller lots where building out isn't feasible.

Can I use a prefab ADU in Utah?

Yes, but the prefab structure is only part of the cost. You still need a foundation, site work, utility connections, permitting, and inspections — all governed by local code. Total project cost for a prefab ADU in Utah is typically $150,000–$300,000.

How many parking spaces do I need for a detached ADU?

Most cities require one additional off-street space. Cottonwood Heights requires two. Spanish Fork requires four. Parking cannot typically be tandem (one car blocking another). This is a common feasibility-killer on tight lots.

Can I Airbnb a detached ADU in Utah?

In most Wasatch Front cities, no. Salt Lake City, Millcreek, and Salt Lake County all prohibit short-term rentals in detached ADUs. Some cities allow short-term rentals in internal/attached units but ban it in detached structures. Long-term rentals (30+ days) are widely allowed.

Do I need to live on the property to have a detached ADU?

Yes, in nearly every Utah jurisdiction. Owner occupancy of either the main home or the ADU is required. Most cities require recording an affidavit. Short exceptions may apply for military, medical, or religious missions (Salt Lake County allows up to 2 years).

Can I sell the ADU separately from my home?

No. ADUs in Utah cannot be subdivided or sold independently from the primary dwelling. They are part of the same lot. However, a home with a permitted, income-producing ADU is significantly more valuable to buyers.

Will a detached ADU raise my property taxes?

Yes. You're adding assessed value to your property, so property taxes will increase. The exact amount depends on your ADU's appraised value, your county's tax rate, and any applicable exemptions. For most homeowners, the increase is easily offset by rental income.

How long does detached ADU permitting take?

1–4 months, depending on your city's backlog, plan complexity, and whether you use pre-approved plans. SLC's pre-approved plans can shave 4–8 weeks. Cities that require Planning Commission review (like Millcreek for new detached ADUs) trend toward the longer end.

What should I do before paying an architect or builder?

Get a feasibility check on your lot. Confirm zoning, lot size, setbacks, parking, utility access, and HOA status. A qualified builder will do this as part of a free initial consultation. This is the single most important step — and it should cost you nothing.

What if my HOA says no to a detached ADU?

For internal ADUs, state law protects you — HOAs cannot prohibit compliant internal ADUs (Utah Code §10-21-303, formerly §10-9a-530). For detached ADUs, your HOA may have authority through CC&Rs to restrict or prohibit them. If you're unsure, contact the Utah Office of the Property Rights Ombudsman.

What if my city doesn't allow detached ADUs?

Your options are internal (basement) ADU — which state law requires all municipalities to allow — or attached ADU, depending on your city's code. ADU ordinances are evolving across Utah, so check with your planning department for the latest status.

Ready to See If a Detached ADU Works on Your Lot?

You've done the research. You know the costs, the rules, and what to look for in a builder. Now it's time for the step that actually matters: find out whether your specific property qualifies and what it would realistically cost.

Our free feasibility estimate includes:

  • Zoning verification for your exact address
  • Lot size, setback, and coverage analysis against your city's current rules
  • Preliminary ADU placement options on your property
  • Ballpark cost range based on your goals, lot conditions, and finish preferences
  • Builder-type recommendation — design-build, architect + GC, prefab, or conversion
  • Honest assessment — including whether a different ADU type would be smarter for your situation

Get My Free Detached ADU Feasibility Estimate

No obligation. No pressure. No deposit. Just clear answers from our team and, when appropriate, a vetted licensed Utah ADU builder in our network.

Not ready for an estimate yet? Explore our city-specific ADU guides:

© 2026 Utah ADU Builders. This guide is provided for informational purposes and is updated regularly. It does not constitute legal, financial, or tax advice. City rules verified March 2026. Always confirm with your local planning department before committing to any construction project.
